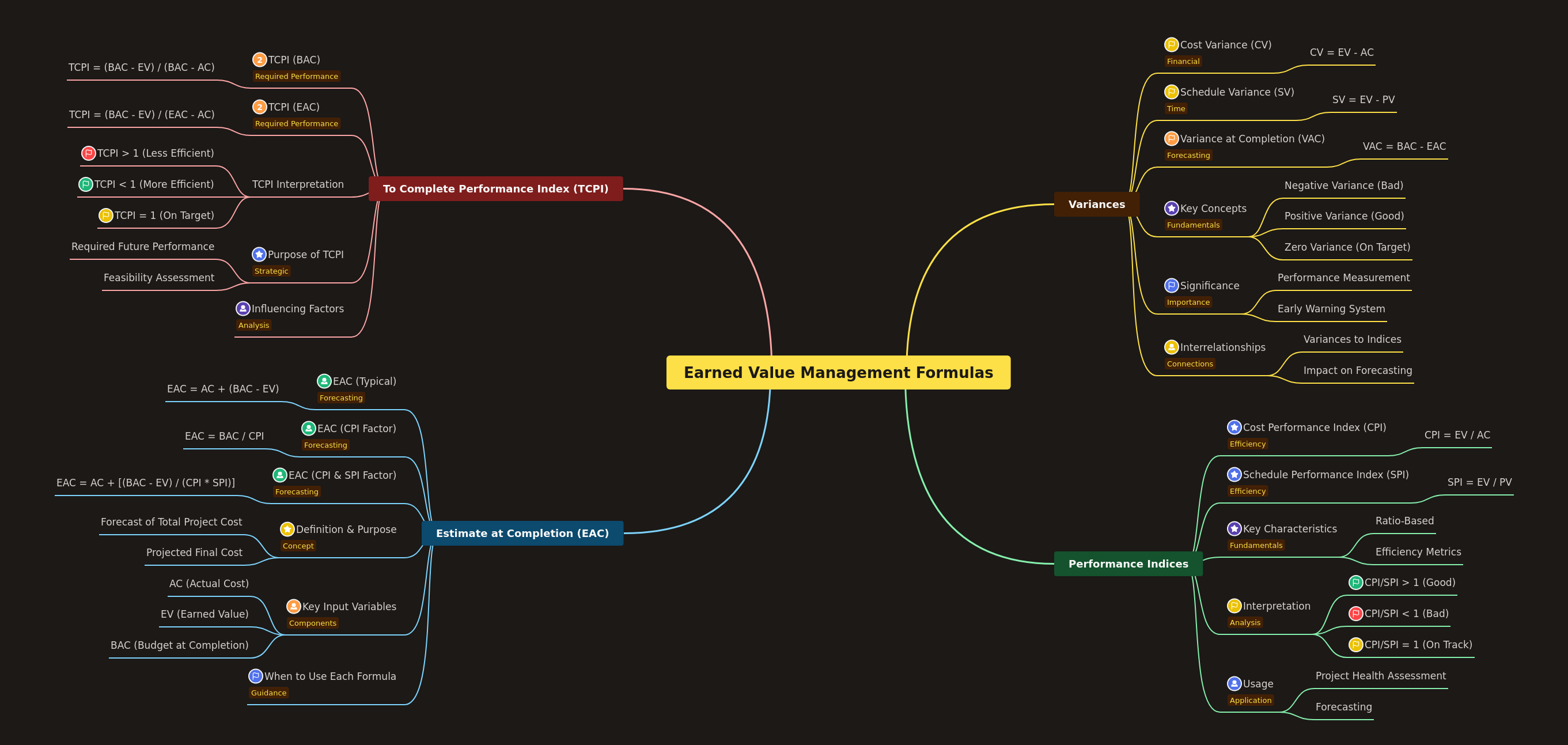

Earned Value Management Formulas Explained
Earned Value Management (EVM) formulas are essential tools for project managers to objectively measure project performance, predict future outcomes, and manage costs and schedules effectively. They provide quantitative insights into project health by comparing planned work, earned value, and actual costs, enabling proactive decision-making and control throughout the project lifecycle.
Key Takeaways
EVM formulas quantify project performance.
Variances show deviations from plan.
Indices measure cost and schedule efficiency.
EAC forecasts total project cost.
TCPI indicates future performance needed.
What are Variances in Earned Value Management and Why are They Important?
Variances in Earned Value Management (EVM) serve as crucial quantitative indicators that measure the deviation of actual project performance from the established baseline, specifically in terms of cost and schedule. These metrics are indispensable for project managers to gain immediate insight into whether a project is progressing as planned or if it is encountering significant challenges. By calculating variances, teams can quickly identify if they are over budget, under budget, ahead of schedule, or behind schedule, enabling prompt and informed decision-making. This early warning system allows for timely corrective actions, preventing minor issues from escalating into major project failures and ensuring the project remains aligned with its strategic objectives and stakeholder expectations.
- Cost Variance (CV): Quantifies the difference between earned value and actual cost (CV = EV - AC), indicating financial performance relative to the work completed.
- Schedule Variance (SV): Measures the difference between earned value and planned value (SV = EV - PV), revealing schedule progress against the project timeline.
- Variance at Completion (VAC): Forecasts the expected difference between the Budget at Completion (BAC) and the Estimate at Completion (EAC), providing a final cost deviation projection.
- Key Concepts: A negative variance signifies an unfavorable outcome (e.g., over budget, behind schedule), while a positive variance indicates favorable performance.
- Significance: Variances are vital for performance measurement, offering an objective assessment of project health and acting as an essential early warning system for potential problems.
- Interrelationships: These variances directly influence other EVM metrics like performance indices and are critical inputs for accurate project forecasting and strategic adjustments.
How do Performance Indices Measure Project Efficiency and Guide Decision-Making?
Performance Indices within Earned Value Management (EVM) are powerful ratio-based metrics designed to assess the efficiency of project execution, providing a clear and concise indication of how effectively project resources are being utilized. These indices compare the earned value of work performed against either the actual costs incurred or the planned value of work scheduled, offering a comprehensive view of project health. A value greater than one consistently signifies efficient performance, indicating that the project is delivering more value per unit of cost or time than planned. Conversely, a value less than one points to inefficiencies, signaling potential issues that require immediate attention. Project managers leverage these indices to continuously monitor project progress, identify performance trends, and make data-driven decisions regarding resource allocation, scope adjustments, and overall strategic direction.
- Cost Performance Index (CPI): Evaluates cost efficiency by dividing earned value by actual cost (CPI = EV / AC), showing value earned per dollar spent.
- Schedule Performance Index (SPI): Assesses schedule efficiency by dividing earned value by planned value (SPI = EV / PV), indicating progress against the schedule.
- Key Characteristics: These indices are inherently ratio-based, providing a standardized, easily interpretable measure of efficiency across different project scales and types.
- Interpretation: A CPI or SPI greater than 1 is favorable, less than 1 is unfavorable, and exactly 1 means the project is performing precisely on target.
- Usage: Performance indices are indispensable for comprehensive project health assessment, enabling accurate forecasting, and supporting strategic decision-making throughout the project lifecycle.
What is Estimate at Completion (EAC) and How Do Different Formulas Aid Forecasting?
The Estimate at Completion (EAC) is a critically important forecasting metric in Earned Value Management, providing a dynamic projection of the total cost required to complete the entire project based on current performance trends. Unlike the initial Budget at Completion (BAC), EAC offers a revised, more realistic estimate of the final project cost, allowing stakeholders to anticipate potential budget overruns or underruns well in advance. Project managers utilize various formulas to calculate EAC, each tailored to different assumptions about future project performance, such as whether past inefficiencies will continue or if future work will proceed at the planned rate. These calculations are essential for re-evaluating project viability, justifying requests for additional funding, or making necessary adjustments to project scope and resources to meet financial constraints. EAC is a living forecast, updated regularly to reflect the most current project status and performance.
- EAC (Typical): Calculated as Actual Cost plus the remaining budget (BAC - EV), assuming future work will be completed at the planned rate. (EAC = AC + (BAC - EV))
- EAC (CPI Factor): Derived by dividing the Budget at Completion by the Cost Performance Index, assuming future cost efficiency will mirror past performance. (EAC = BAC / CPI)
- EAC (CPI & SPI Factor): A more complex formula that considers both cost and schedule performance, assuming future efficiency is influenced by both. (EAC = AC + [(BAC - EV) / (CPI * SPI)])
- Definition & Purpose: EAC's core purpose is to provide a forecast of the total project cost, offering a projected final cost that reflects current realities rather than just initial plans.
- Key Input Variables: Accurate EAC calculations depend on reliable data for Actual Cost (AC), Earned Value (EV), and the original Budget at Completion (BAC).
- When to Use Each Formula: The choice of EAC formula depends on the project's specific circumstances and the assumptions made about the likelihood of past performance continuing into the future.
Why is the To Complete Performance Index (TCPI) Crucial for Future Project Performance?
The To Complete Performance Index (TCPI) is a forward-looking metric within Earned Value Management that quantifies the cost efficiency required for the remaining project work to meet a specific financial target, either the original Budget at Completion (BAC) or a newly established Estimate at Completion (EAC). This index is exceptionally valuable for project managers as it provides a clear benchmark for future performance, helping to assess the feasibility of achieving budget goals. A TCPI value greater than one indicates that the remaining work must be completed at a higher efficiency rate than what has been achieved so far, often signaling a need for significant intervention, re-planning, or scope reduction. Conversely, a TCPI less than one suggests that the remaining work can be completed with less efficiency, offering some buffer. This index is crucial for strategic planning, realistic goal setting, and making informed decisions about the project's future trajectory.
- TCPI (BAC): Calculates the efficiency needed to complete the project within the original Budget at Completion. (TCPI = (BAC - EV) / (BAC - AC))
- TCPI (EAC): Determines the efficiency required to complete the project within the revised Estimate at Completion, reflecting current realities. (TCPI = (BAC - EV) / (EAC - AC))
- TCPI Interpretation: A TCPI greater than 1 implies a challenging path ahead, requiring improved efficiency; less than 1 suggests an easier path; and 1 means maintaining current efficiency.
- Purpose of TCPI: Its primary purpose is to establish the required future performance level, serving as a critical tool for feasibility assessment and strategic adjustments to ensure project success.
- Influencing Factors: TCPI is influenced by current project performance (EV, AC), the original budget (BAC), and any revised cost forecasts (EAC), making it a dynamic and responsive metric.
Frequently Asked Questions
What is the primary goal of Earned Value Management formulas?
The primary goal is to objectively measure project performance, identify deviations from the plan, and forecast future outcomes. This enables proactive management of project costs and schedules, ensuring better control and successful delivery.
When should a project manager use CPI and SPI?
Project managers should use CPI and SPI continuously to monitor cost and schedule efficiency. These indices provide real-time insights into how effectively resources are being utilized and if the project is progressing as planned, guiding immediate adjustments.
How does EAC differ from BAC in project management?
BAC (Budget at Completion) is the total planned budget for the project. EAC (Estimate at Completion) is a dynamic forecast of the total project cost based on current performance, providing a revised, more realistic final cost projection.
