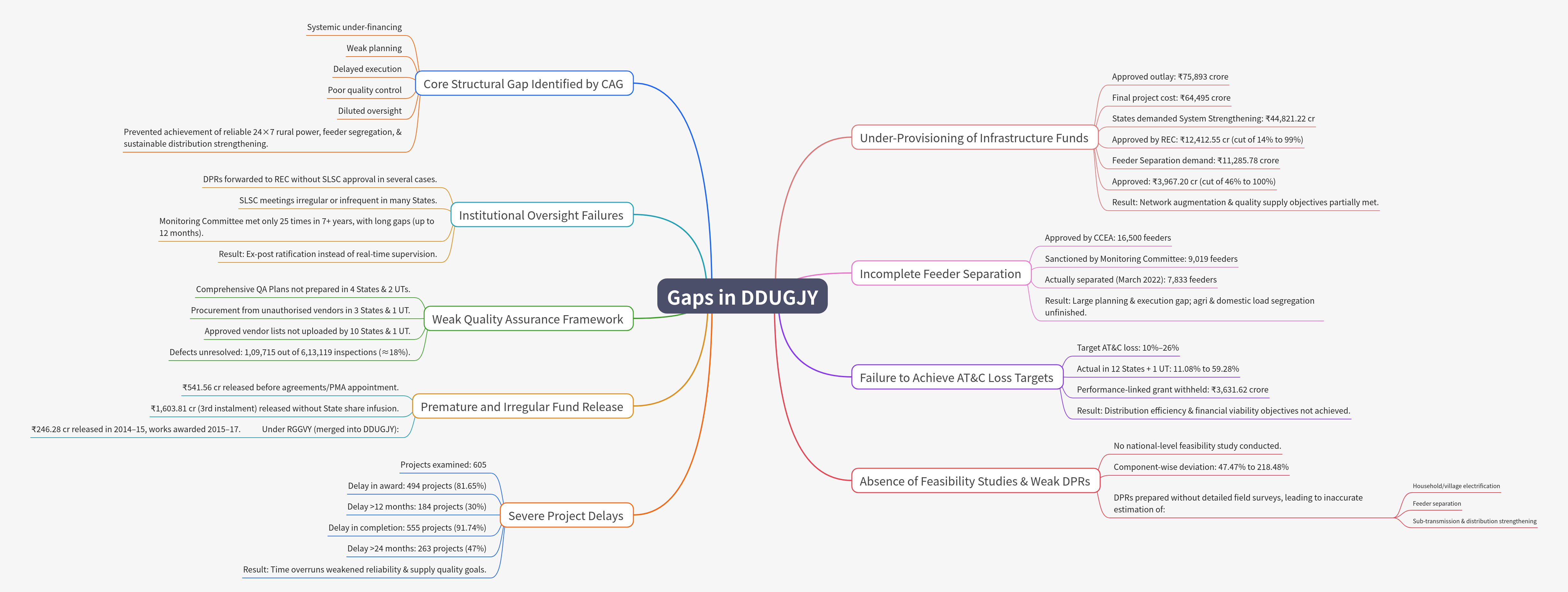

Gaps in DDUGJY Implementation Analysis
The Deendayal Upadhyaya Gram Jyoti Yojana (DDUGJY) faced significant implementation challenges, including under-provisioning of infrastructure funds, incomplete feeder separation, and failure to meet AT&C loss targets. These issues, coupled with severe project delays, weak quality assurance, and institutional oversight failures, collectively hindered the scheme's objectives of reliable rural power supply and distribution strengthening.
Key Takeaways
Funding cuts severely impacted infrastructure augmentation.
Feeder separation targets remained largely unachieved.
High AT&C losses undermined financial viability.
Poor planning and oversight led to widespread project delays.
Why did DDUGJY face under-provisioning of infrastructure funds?
The Deendayal Upadhyaya Gram Jyoti Yojana (DDUGJY) encountered significant under-provisioning of infrastructure funds, primarily due to substantial cuts in approved outlays versus actual project costs and state demands. States requested significant funds for system strengthening and feeder separation, but approvals by REC were drastically reduced, sometimes by over 90%. This severe reduction in allocated funds directly resulted in network augmentation and quality supply objectives being only partially met, hindering the scheme's overall effectiveness in improving rural electricity infrastructure.
- Approved outlay: ₹75,893 crore.
- System strengthening funds cut.
- Feeder separation funds cut.
What caused the incomplete feeder separation in DDUGJY?
Incomplete feeder separation was a major gap in DDUGJY, stemming from a significant discrepancy between approved targets and actual implementation. While 16,500 feeders were approved by CCEA, only 9,019 were sanctioned by the Monitoring Committee, and merely 7,833 were actually separated by March 2022. This substantial planning and execution gap meant that the crucial segregation of agricultural and domestic loads remained unfinished. Consequently, the scheme failed to fully achieve its objective of providing dedicated power supply to different consumer categories.
- CCEA approved 16,500 feeders.
- Only 7,833 feeders separated.
- Agri and domestic load segregation unfinished.
Why did DDUGJY fail to achieve its AT&C loss targets?
The DDUGJY scheme largely failed to achieve its Aggregate Technical & Commercial (AT&C) loss targets, which were set between 10% and 26%. Actual losses in 12 states and one UT ranged from 11.08% to a staggering 59.28%, significantly exceeding the desired benchmarks. This persistent failure led to the withholding of performance-linked grants totaling ₹3,631.62 crore. Ultimately, the inability to control AT&C losses meant that the program's objectives of improving distribution efficiency and ensuring the financial viability of power utilities were not achieved, impacting long-term sustainability.
- Target AT&C loss: 10%–26%.
- Actual losses up to 59.28%.
- Performance grants withheld.
How did weak planning impact DDUGJY implementation?
Weak planning significantly impacted DDUGJY implementation, primarily due to the absence of national-level feasibility studies and the preparation of weak Detailed Project Reports (DPRs). DPRs were often developed without thorough field surveys, leading to inaccurate estimations for critical components like household electrification, feeder separation, and sub-transmission strengthening. This lack of foundational analysis resulted in component-wise deviations ranging from 47.47% to 218.48%. Such deficiencies in initial planning undermined the entire project, causing inefficiencies and misallocation of resources throughout its execution phase.
- No national feasibility study.
- DPRs lacked detailed surveys.
- Inaccurate project estimations.
What were the consequences of severe project delays in DDUGJY?
Severe project delays significantly hampered the DDUGJY, undermining its core objectives of reliable and quality power supply. An examination of 605 projects revealed that 81.65% experienced delays in award, with 30% delayed by over 12 months. Furthermore, 91.74% of projects faced completion delays, and nearly half (47%) were delayed by more than 24 months. These extensive time overruns directly weakened the scheme's ability to deliver reliable electricity and achieve its supply quality goals, leading to prolonged periods without improved infrastructure for rural communities.
- 81.65% projects delayed in award.
- 91.74% projects delayed in completion.
- Weakened reliability and supply quality.
How did irregular fund release affect DDUGJY projects?
Irregular and premature fund releases significantly undermined the financial integrity and efficient execution of DDUGJY projects. Instances included ₹541.56 crore released before essential agreements or Project Management Agency (PMA) appointments were finalized. Additionally, ₹1,603.81 crore, intended as a third installment, was disbursed without the required state share infusion. Under the merged RGGVY scheme, ₹246.28 crore was released in 2014–15, but works were only awarded between 2015–17. Such practices led to inefficient fund utilization and potential financial mismanagement, hindering timely project progress and accountability.
- Funds released before agreements.
- Third installment without state share.
- Delayed work awards post-release.
What were the weaknesses in DDUGJY's quality assurance?
DDUGJY suffered from a weak quality assurance framework, compromising the integrity and longevity of its infrastructure. Comprehensive Quality Assurance Plans were not prepared in four states and two Union Territories. Procurement from unauthorized vendors occurred in three states and one UT, while ten states and one UT failed to upload approved vendor lists. Alarmingly, approximately 18% of inspected defects (109,715 out of 613,119) remained unresolved. These systemic failures in quality control led to substandard infrastructure, reducing the reliability and effectiveness of the newly installed power systems across rural areas.
- No comprehensive QA plans.
- Procurement from unauthorized vendors.
- Many defects remained unresolved.
What institutional oversight failures impacted DDUGJY?
Institutional oversight failures significantly impacted DDUGJY, leading to a lack of real-time supervision and accountability. Detailed Project Reports (DPRs) were often forwarded to REC without State Level Standing Committee (SLSC) approval. SLSC meetings were irregular or infrequent in many states, hindering timely reviews. The Monitoring Committee, crucial for overall scheme oversight, met only 25 times over seven years, with gaps extending up to 12 months. This resulted in ex-post ratification rather than proactive supervision, allowing issues to escalate and project deficiencies to persist without adequate intervention.
- DPRs lacked SLSC approval.
- Irregular SLSC meetings.
- Infrequent Monitoring Committee meetings.
What core structural gaps did the CAG identify in DDUGJY?
The Comptroller and Auditor General (CAG) identified several core structural gaps in DDUGJY, highlighting systemic issues that prevented the scheme from achieving its full potential. These included pervasive under-financing, weak planning, delayed execution, poor quality control, and diluted oversight. Collectively, these deficiencies prevented the achievement of reliable 24×7 rural power, effective feeder segregation, and sustainable distribution strengthening. The CAG's findings underscored a fundamental flaw in the program's design and implementation, indicating that without addressing these core issues, similar schemes would likely face comparable challenges.
- Systemic under-financing.
- Weak planning and execution.
- Diluted oversight and poor quality.
Frequently Asked Questions
What was the primary goal of the DDUGJY scheme?
The DDUGJY aimed to provide continuous and quality power supply to rural areas, strengthen sub-transmission and distribution infrastructure, and separate agricultural and non-agricultural feeders.
How did funding issues affect DDUGJY projects?
Significant cuts in approved outlays and state demands led to under-provisioning of funds, partially meeting network augmentation and quality supply objectives. This hindered infrastructure development.
Why was feeder separation incomplete under DDUGJY?
A large gap existed between approved feeder separation targets and actual implementation, leaving agricultural and domestic load segregation unfinished due to planning and execution deficiencies.
What impact did project delays have on DDUGJY?
Extensive project delays, with many exceeding two years, weakened the scheme's ability to deliver reliable electricity and achieve its supply quality goals for rural communities.
What were the main institutional oversight problems in DDUGJY?
Oversight failures included irregular committee meetings, DPRs lacking necessary approvals, and a general shift towards ex-post ratification instead of proactive, real-time supervision.
